Window Replacement & Lead-Safe Renovation Notice 🛡️ 2026 OSHA/FHA Compliant

Execute window replacement safely while strictly complying with EPA Lead-Safe (RRP) practices, managing OSHA dust containment protocols, and protecting tenant property from construction damage.

Not just a template.
A reality execution tool.

Don't risk tenant disputes with messy Word docs. Generate a print-ready, OSHA-compliant physical notice in exactly 30 seconds.

  • 1
    Bilingual Architecture English & Spanish integrated into a single US Letter design. Crucial for legal compliance in 14+ states.
  • 2
    Toner-Friendly Print Engineered for black-and-white office printers. High contrast hierarchy ensures readability from 10 feet away.
  • 3
    Locked Formatting Zero layout breakage. Type your details, and the engine physicalizes it without overflowing the page.

WINDOW REPLACEMENT & LEAD-SAFE RENOVATION NOTICE

AVISO DE REEMPLAZO DE VENTANAS Y RENOVACIÓN SEGURA

Date / Fecha November 12, 2026
Area / Área Building 4, All North-Facing Units

Why use this template?

  • Bilingual output (English/Spanish) prevents FHA liability
  • Formatted strictly for US Letter B&W physical printing
  • Zero JS bloat, generates instantly in your browser

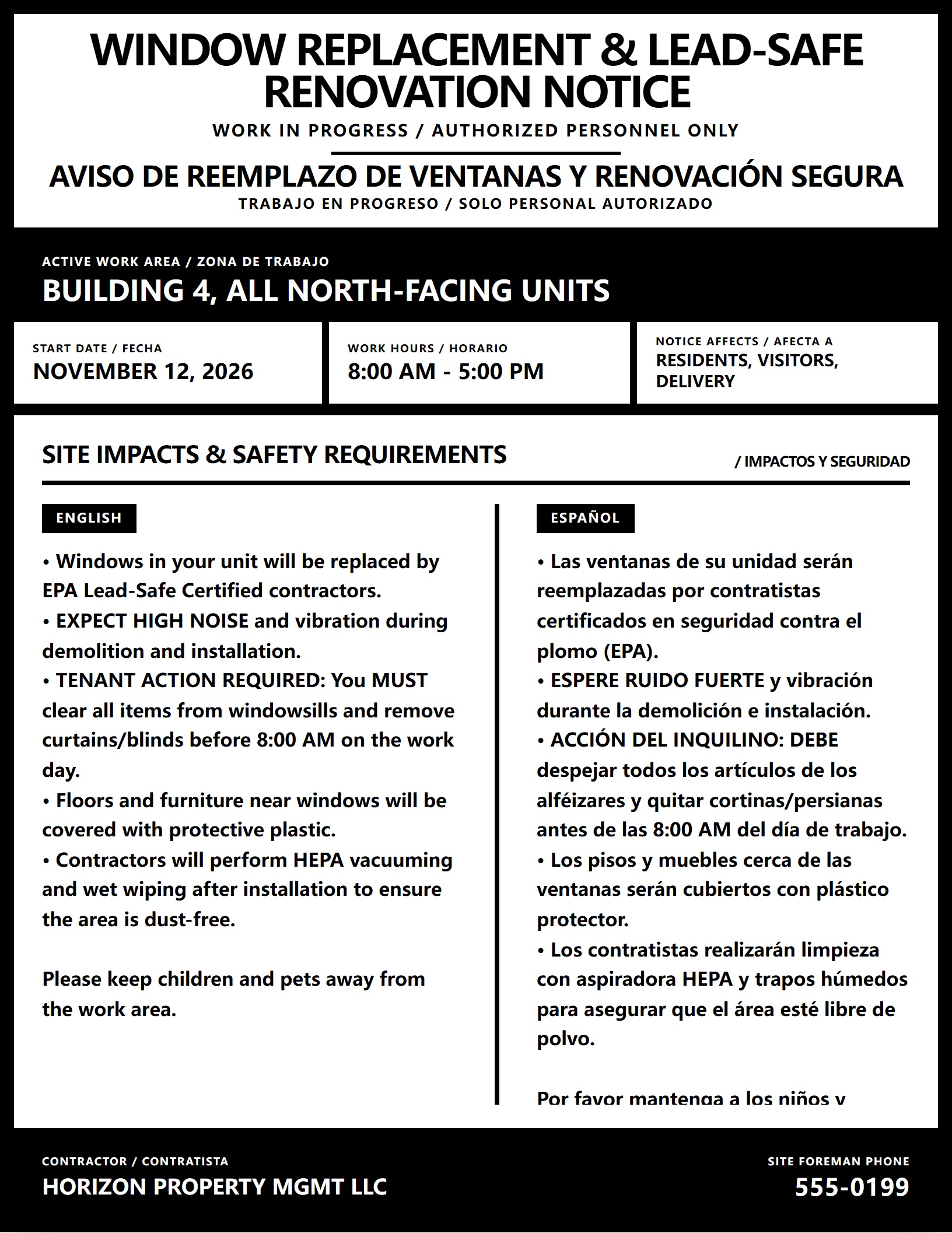

Print Output Preview

Free printable bilingual window replacement & lead-safe renovation notice sample for apartments (FHA compliant)
View Details
Free printable bilingual window replacement & lead-safe renovation notice sample for apartments (FHA compliant)

📋 Field Execution Asset

Download the OSHA-compliant manager checklist to ensure zero liability on-site.

🏠 Tenant Distribution Asset

Attach this prep-guide to your notice to reduce tenant front-desk calls by 60%.

Notice Editor & Preview

Edit Notice

17 / 30
17 / 30
34 / 60
518 / 500

Warning: Default text exceeds limit (518/500). Please shorten it.

608 / 500

Warning: Default text exceeds limit (608/500). Please shorten it.

25 / 50
8 / 30

Live Print Preview

US Letter • 8.5" x 11"

WINDOW REPLACEMENT & LEAD-SAFE RENOVATION NOTICE

WORK IN PROGRESS / AUTHORIZED PERSONNEL ONLY

AVISO DE REEMPLAZO DE VENTANAS Y RENOVACIÓN SEGURA

TRABAJO EN PROGRESO / SOLO PERSONAL AUTORIZADO

Active Work Area / Zona de Trabajo

Building 4, All North-Facing Units

Start Date / Fecha

November 12, 2026

Work Hours / Horario

8:00 AM - 5:00 PM

Notice Affects / Afecta A

Residents, Visitors, Delivery

SITE IMPACTS & SAFETY REQUIREMENTS/ Impactos y Seguridad

English
• Windows in your unit will be replaced by EPA Lead-Safe Certified contractors. • EXPECT HIGH NOISE and vibration during demolition and installation. • TENANT ACTION REQUIRED: You MUST clear all items from windowsills and remove curtains/blinds before 8:00 AM on the work day. • Floors and furniture near windows will be covered with protective plastic. • Contractors will perform HEPA vacuuming and wet wiping after installation to ensure the area is dust-free. Please keep children and pets away from the work area.
Español
• Las ventanas de su unidad serán reemplazadas por contratistas certificados en seguridad contra el plomo (EPA). • ESPERE RUIDO FUERTE y vibración durante la demolición e instalación. • ACCIÓN DEL INQUILINO: DEBE despejar todos los artículos de los alféizares y quitar cortinas/persianas antes de las 8:00 AM del día de trabajo. • Los pisos y muebles cerca de las ventanas serán cubiertos con plástico protector. • Los contratistas realizarán limpieza con aspiradora HEPA y trapos húmedos para asegurar que el área esté libre de polvo. Por favor mantenga a los niños y mascotas alejados del área de trabajo.

Contractor / Contratista

Horizon Property Mgmt LLC

Site Foreman Phone

555-0199

Legal Deadline Calculator

Powered by US Office of Personnel Management (OPM) rules.

72h Target

Send Digital Blast (Portal + SMS)

Jun 23by 9:00 AM
48h Target

Post Physical Bilingual Notices

Jun 24by 9:00 AM
24h Target

Verify EPA Lead-Safe Certification

Jun 25by 9:00 AM
1h Target

Setup Interior/Exterior Containment

Jun 26by 8:00 AM
0h Target

Execute Window Demolition & Install

Jun 26by 9:00 AM
Execution Begins
2026-06-26 at 09:00

Compliance & Legal Disclaimer: Calculations are strictly based on U.S. Office of Personnel Management (OPM) observed federal holiday rules and standard weekend exclusions. While this tool is designed for enterprise-grade accuracy regarding FLSA and standard property management protocols (e.g., CA Civil Code §1950.5), local municipal codes may vary. NoticeMint is a workflow software, not a law firm. Always verify critical statutory deadlines with your legal counsel.

Execution Protocol

Operational Timeline & Compliance Checklist

Live Implementation Guide
  1. 72 Hours Before Responsible: system AUTOMATABLE

    Send Digital Blast (Portal + SMS)

    ⚠️

    Liability Alert

    For buildings built before 1978, federal law (EPA RRP Rule) requires specific lead hazard warnings in the notification.

    💡

    Pro Strategy

    Explicitly mention high noise levels and lead dust containment procedures to manage tenant anxiety and set expectations.

  2. 48 Hours Before Responsible: property manager

    Post Physical Bilingual Notices at Lobby, Elevator, Mailroom, Building Entrance

    ⚠️

    Liability Alert

    Do NOT post notices on fire-rated doors or block exit pathways with construction signage.

    💡

    Pro Strategy

    Post notices in common areas, but ALSO deliver a physical copy directly to the affected units or slide it under their doors.

  3. 24 Hours Before Responsible: property manager

    Verify EPA Lead-Safe Certification

    ⚠️

    Liability Alert

    Using an uncertified contractor for window replacement in a pre-1978 building carries federal fines up to $37,500 per violation.

    💡

    Pro Strategy

    Request and file a copy of the contractor's EPA Lead-Safe Certified Firm certificate and the assigned Renovator's training card before they step on site.

  4. Morning of Work Responsible: contractor

    Setup Interior/Exterior Containment

    ⚠️

    Liability Alert

    HVAC vents in the workroom must be sealed with plastic and tape to prevent lead dust from circulating through the building's ductwork.

    💡

    Pro Strategy

    Contractors must lay heavy-duty polyethylene sheeting on floors (extending 6 feet from the work area) and cover all immovable furniture.

  5. Start Time Responsible: contractor

    Execute Window Demolition & Install

    ⚠️

    Liability Alert

    Extreme noise and vibration. Ensure exterior drop zones are barricaded to protect pedestrians from falling debris or old window sashes.

  6. Post-Install Responsible: contractor

    HEPA Cleanup & Clearance Testing

    💡

    Pro Strategy

    Contractor must perform HEPA vacuuming and wet wiping of all surfaces within the containment zone. For pre-1978 buildings, a third-party dust wipe clearance test is highly recommended.

  7. Within 2 Hours After Responsible: property manager

    Remove Outdated Notices & Barricades at Lobby, Elevator, Mailroom, Building Entrance

    ⚠️

    Liability Alert

    Ensure all exterior caution tape and barricades are removed so they do not become tripping hazards or ADA violations overnight.

Required Posting Locations

Physical Distribution Checklist

  • Lobby
  • Elevator
  • Mailroom
  • Building Entrance

Liability Defense Rule

Always take a timestamped wide-angle photo of the posted notice in its physical location. If a tenant claims they were not notified, this photo is your primary legal defense.

Tenant Communication Brief

Anticipated Questions & Official Responses

Stage: 72 Hours Before
Q

Do I need to leave my apartment during the work?

"You are not legally required to leave, but it is highly recommended that children, pregnant women, and pets stay away from the work area due to noise and potential lead dust.
Q

Will the contractors enter my bedroom/living room?

"Yes. Contractors will need interior access to the windows. They will lay down protective plastic sheeting over your floors and furniture near the windows.
Stage: Post-Install
Q

Is it safe to touch the windowsill now?

"Yes, after the contractor completes the HEPA vacuuming and wet wiping protocol, the area is certified safe for normal contact.
Q

What if I see dust after they leave?

"Do not sweep or dry dust it, as this puts lead particles into the air. Use a wet paper towel to wipe it up, or contact management immediately for a professional re-clean.
📢

Manager's Note

Providing these answers in your initial notice can reduce management office phone volume by up to 60% during service interruptions.

📘

Operational Guidance

Industry Best Practices & Field-Tested Strategies

1

Always verify and file the contractor's EPA Lead-Safe Certified Firm certificate and the assigned Renovator's training card before work begins (mandatory for pre-1978 buildings).

2

Deliver physical notices directly to affected units (slide under door or hand-deliver) at least 48 hours prior, in addition to common area postings.

3

Require tenants to clear windowsills and remove window treatments (blinds/curtains) the night before. Property management is generally not liable for damage to items left in the work zone if properly noticed.

4

Ensure contractors seal all HVAC vents in the workroom with plastic and tape to prevent lead dust from migrating through the building's ductwork.

5

For pre-1978 buildings, hire an independent third-party environmental hygienist to perform post-renovation dust wipe clearance testing. This is your ultimate legal shield against lead exposure claims.

Manager Checklist

  • Verify building construction year to determine if EPA RRP Lead-Safe rules apply
  • Collect and file contractor's EPA Lead-Safe Firm Certificate and Renovator cards
  • Send digital blast (portal + SMS + email) 72 hours before work begins
  • Deliver physical bilingual notices to affected units and post in common areas 48 hours prior
  • Walk affected units the evening before to verify tenants have cleared windowsills and removed blinds
  • Verify contractors have sealed HVAC vents and laid 6-foot floor containment sheeting before demo starts
  • Ensure exterior drop zones are barricaded with caution tape to protect pedestrians
  • Conduct post-installation visual inspection to ensure no visible dust or debris remains
  • Schedule third-party dust wipe clearance testing (highly recommended for pre-1978 buildings)
  • Remove all notices, barricades, and caution tape within 2 hours of project completion
⚠️

Common Costly Mistakes

  • Failing to recognize the building's construction year — if built before 1978, standard window replacement without EPA RRP protocols is a federal violation carrying fines up to $37,500 per day.
  • Allowing contractors to use high-heat guns or high-speed power sanders without HEPA exhaust attachments, which creates highly toxic, airborne lead dust.
  • Skipping the HVAC vent sealing step, resulting in lead dust being blown into adjacent apartments through the central air system.
  • Failing to explicitly warn tenants to remove curtains and clear windowsills, leading to disputes when contractors cut down blinds or damage personal items to access the window frame.
  • Relying solely on the contractor's word that the unit is "clean" without conducting a visual inspection or third-party dust wipe test before signing off on the invoice.
🏠

Resident Preparation Checklist

Include this checklist in your notice to reduce tenant calls by up to 60%

  • Remove ALL personal items, plants, and decorations from the windowsills and within 6 feet of the windows
  • Take down all curtains, drapes, and unhook blinds/rollers (contractors will not reinstall them)
  • Move fragile items and electronics away from the window area to protect them from vibration damage
  • Secure pets in a carrier or a different room away from the construction noise and dust
  • Keep children away from the work zone and ensure they do not touch the protective plastic sheeting
  • Do not attempt to sweep or dry-dust any construction residue; use a wet paper towel if immediate spot cleaning is needed
  • Report any torn plastic containment, uncovered vents, or visible dust in adjacent rooms to management immediately

Frequently Asked Questions

What is the EPA RRP Rule and does it apply to my building?
The Renovation, Repair, and Painting (RRP) Rule requires that contractors working in pre-1978 housing be EPA-certified and use specific lead-safe work practices to prevent lead dust contamination. If your building was built before 1978, these federal rules legally apply to window replacements.
Will the contractors damage my blinds or curtains?
Contractors need unobstructed access to the window frames. You must remove all curtains, drapes, and blinds prior to their arrival. Management and the contractor are not liable for damage to or disposal of window treatments left in the work zone.
Is it safe to stay in the apartment during the window replacement?
While you are not legally required to vacate, the work involves extreme noise, vibration, and potential dust. It is highly recommended that pregnant women, children under 6, and pets stay away from the immediate work area or leave the apartment during active demolition hours.
How do I know the apartment is safe from lead dust after they finish?
Certified contractors are required to perform HEPA vacuuming and wet wiping of all surfaces within the containment zone. For maximum safety, property management may hire an independent environmental hygienist to perform a "dust wipe clearance test," which scientifically verifies the absence of lead hazards.
🛡️ Verified for 2026 Laws Last Legal Review: Jun 18, 2025
⚖️

Disclaimer

  • Federal law (EPA RRP Rule) strictly regulates renovations in pre-1978 housing. Fines for non-compliance can exceed $37,500 per violation, per day.
  • OSHA regulations (29 CFR 1926.62) mandate strict lead exposure limits and protective equipment for the construction workers performing the demolition.
  • This template provides formatting and operational guidance only and does not constitute legal or environmental compliance advice.
  • Always retain copies of all posted notices, contractor certifications, containment setup photos, and third-party clearance test results for your legal and insurance files.
  • Local municipal codes may require specific building permits and noise variance approvals for large-scale window replacement projects.
🔗

Complete your communication workflow with these related notices
